Sprints Tab — Feature Guide

What it’s for
The Sprints tab is the single execution view for a project’s sprint cadence. It combines sprint planning, retrospectives, status, and risk analysis into one stack of expandable sprint rows plus a backlog row. From here a planner can:
- See commitment versus capacity for every active and future sprint at a glance.
- Drag work between sprints and into or out of the backlog.
- Lock issues or whole sprints in place.
- Run automated rebalancing across sprints.
- Start, complete, and delete sprints, including roll-over of unfinished work.
- Switch any row between a forward-looking Sprint view and a Status or Retro view.
The tab is strictly per-project. In “All projects” mode it is replaced with a notice asking the user to pick a single project, because sprint cadences from different projects cannot be summed.

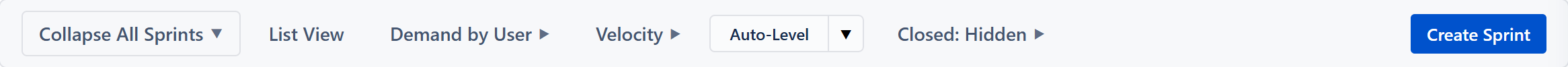

Toolbar

A single row at the top of the tab. Left to right:
Collapse All / Expand All Sprints
Toggles every sprint row plus the backlog open or closed at once. The label flips to “Expand All Sprints” when everything is already collapsed.
List View / Sprint View
List View replaces the per-sprint cards with a single searchable, sortable table of every issue across every sprint plus the backlog. Search filters across key, summary, assignee, sprint name, and status. Click any column heading to sort ascending; click again for descending. Visible columns follow the project’s configured columns.

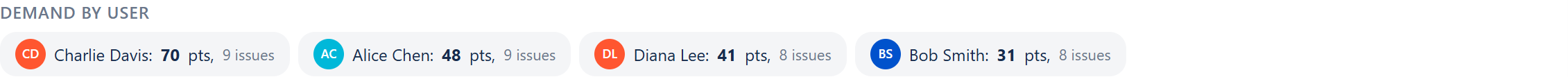

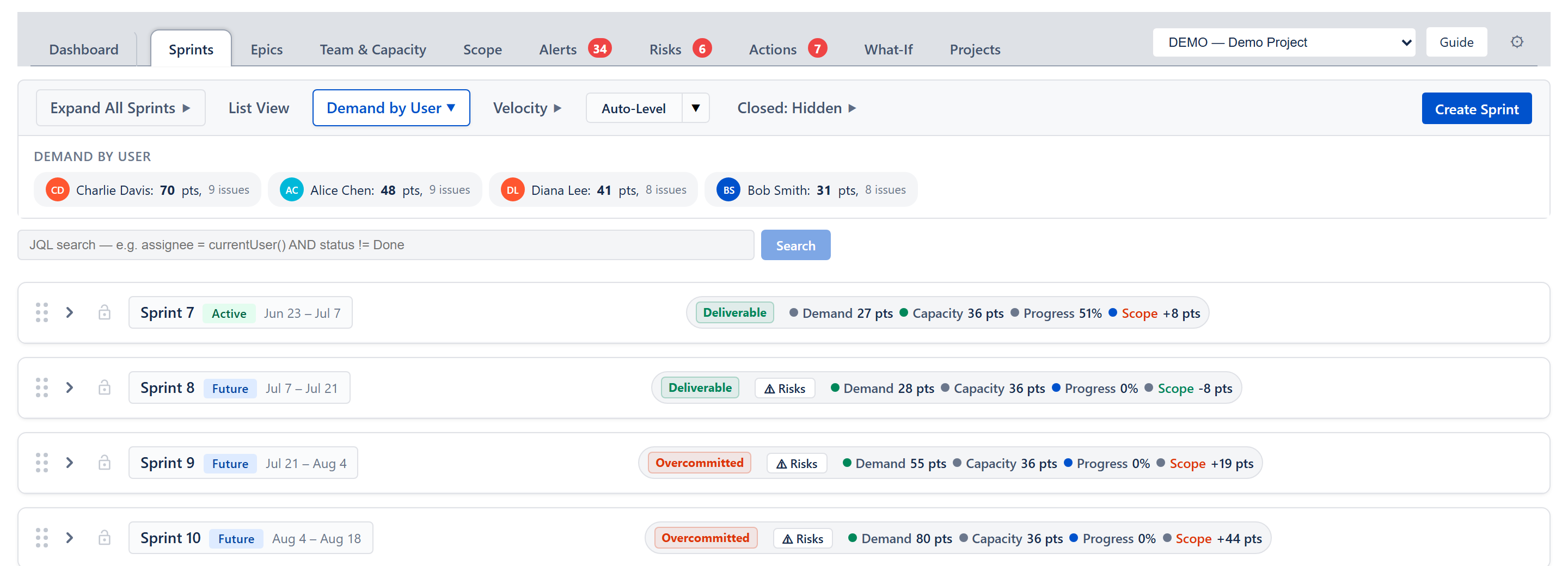

Demand by User

Appears when at least one issue has an assignee. Opens a panel of clickable user chips showing the user’s name, total demand, and issue count. Clicking a chip filters the rest of the application to that user. Clicking the same chip again clears the filter.

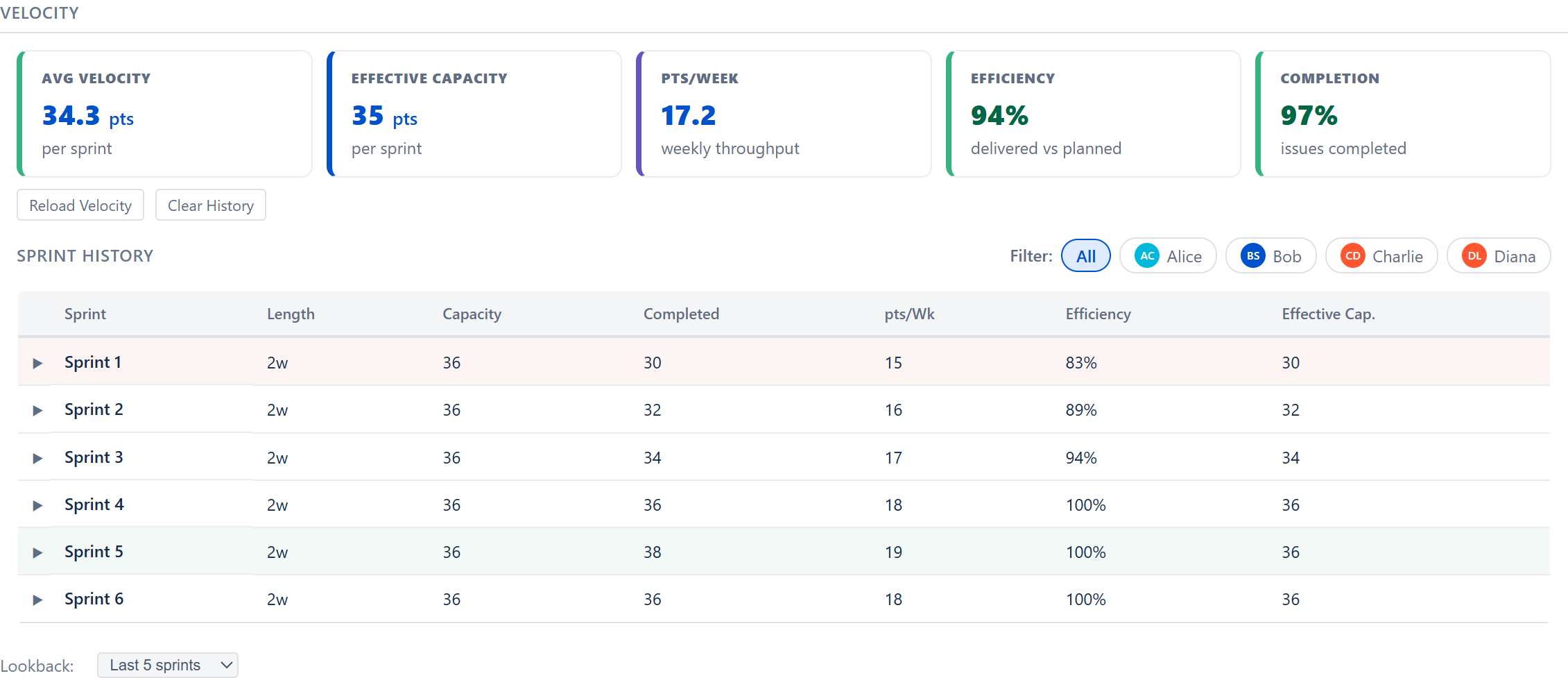

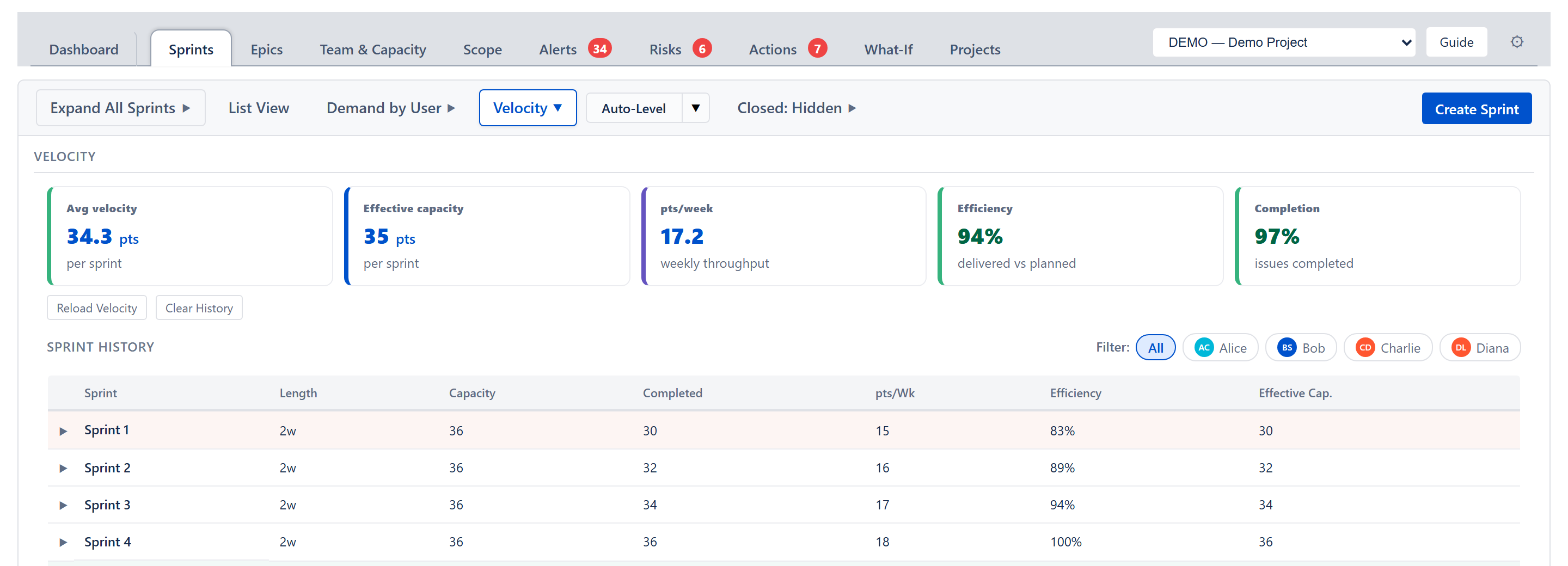

Velocity

Opens an inline panel containing:
- Five summary cards: average velocity, effective capacity, points per week, efficiency, and completion percentage.
- A sprint-history table for closed sprints with length, capacity, completed, points per week, efficiency, and effective capacity. Each row expands to per-member detail.
- Filter chips to view metrics for the whole team or one team member.
- Reload Velocity (refetches the latest history from Jira) and Clear History buttons.
- A Lookback dropdown — Last 3, 5, 8, or 10 sprints — that is shared across every tab.
- An Import History action for bringing in historical velocity data.

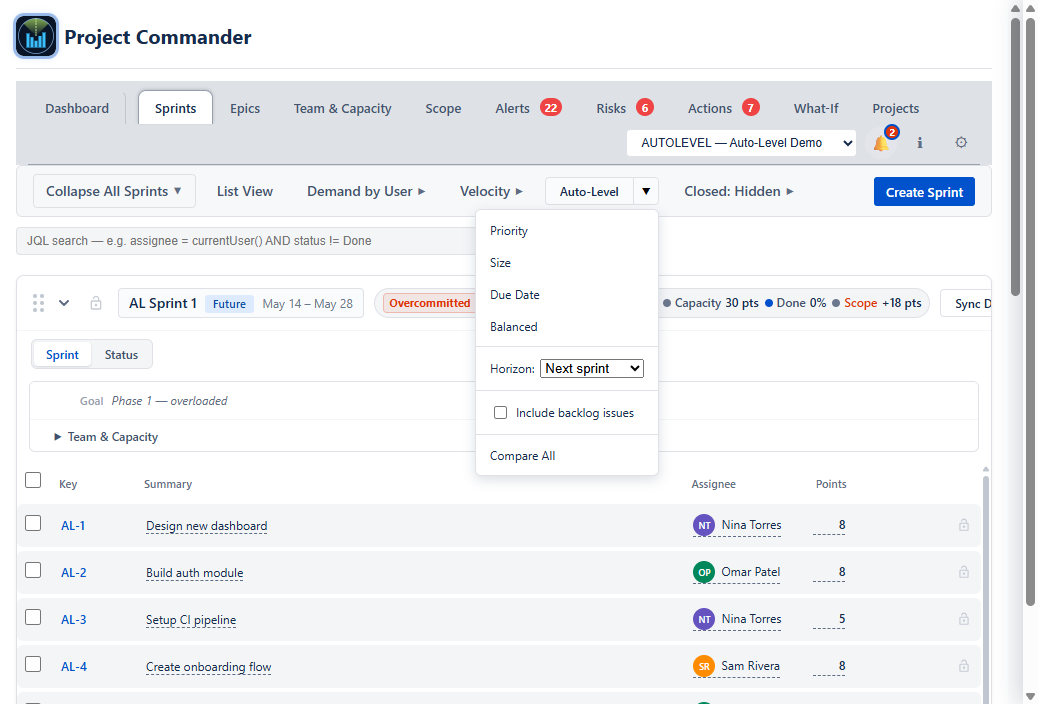

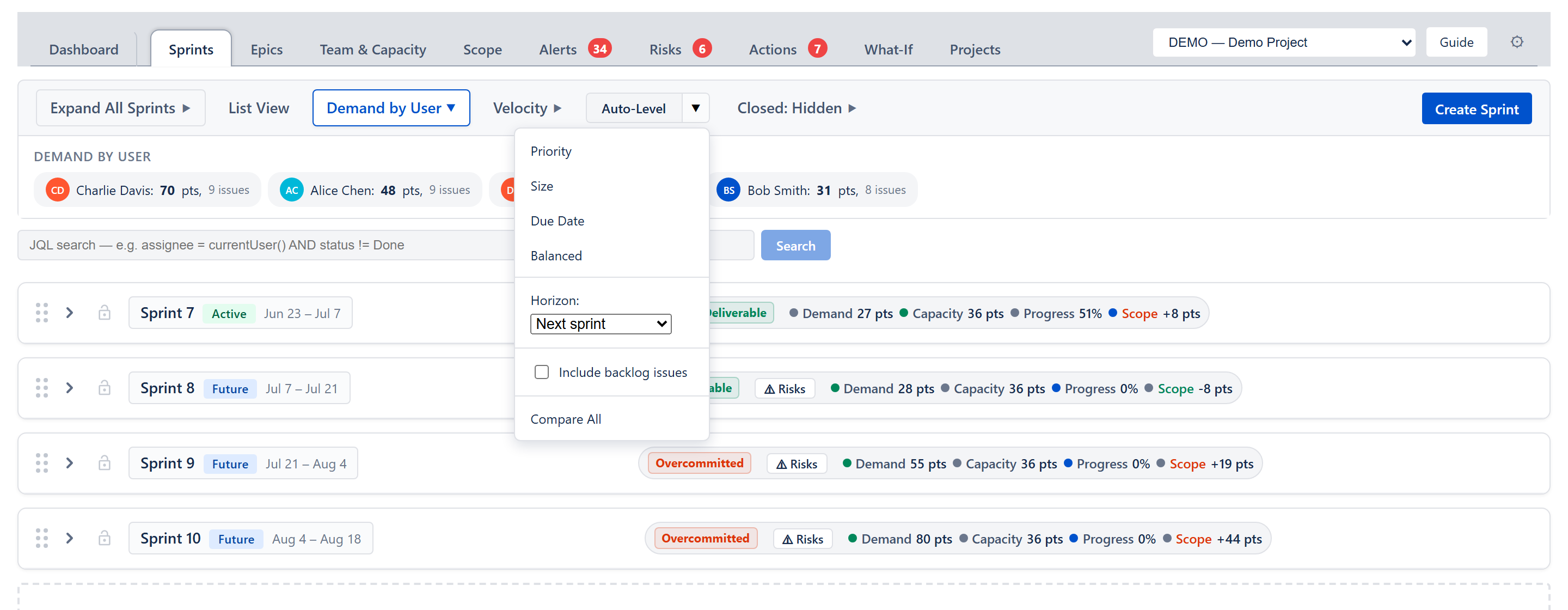

Auto-Level (split button)

Main button starts the rebalance; the chevron opens a strategy menu:
- Priority — fills sprints front to back with highest-priority issues first.
- Size — fills sprints front to back with smallest issues first.
- Due Date — fills sprints front to back with soonest-due issues first.
- Balanced — places the largest issues first into the sprint where they fit best, balancing remaining room and workload.
The same menu also offers:
- Include backlog issues — a checkbox that controls whether the backlog is in scope for Auto-Level and other views.
- Compare All — runs all four strategies in parallel and shows a side-by-side delivery forecast so the planner can pick the best plan.
Selecting a strategy immediately runs a dry-run preview without touching Jira. Selecting a different strategy mid-session swaps the preview to the new arrangement.
Closed sprints chip
A dropdown with four explicit modes for showing historical sprints:
- Hidden — no closed sprints (the default; fastest).
- Last 5 — the five most-recent closed sprints, sorted by end date.
- Last 20 — the twenty most-recent closed sprints.
- All — every closed sprint available.
Closed sprints render inline, interleaved chronologically with active and future sprints by start date (a closed sprint that ran in February sits above an active sprint that started in March, which sits above an April future sprint). The chip just caps how many of the most-recent closed sprints are loaded; their position in the list comes from their dates.
Create Sprint
A primary button on the right. Hidden in read-only mode. Opens a dialog that creates a new sprint on the configured board with a chosen name, start date, end date, and goal.
Auto-Level session

When Auto-Level is active, the toolbar expands with a session panel:
- Legend bar — Auto-levelled, Manually moved, and Locked indicators so the planner can tell why each issue ended up where it did.
- Balance Preview — lists the first twenty proposed moves (issue, summary, from sprint → to sprint, points), with overflow shown as “…and N more”. Apply commits the moves; Cancel exits.
- No-capacity warning if there is no team capacity, no velocity history, and no per-user capacity, so the planner knows the fallback is the global point limit.
- Forecast pill — projected on-time percentage with P50 and P85 sprint estimates, coloured green, amber, or red.
- Skill mismatch panel — when team skills are configured, surfaces per-sprint counts of issues whose assignee lacks required skills. Hover lists the issues and missing skills.
- AI Review — when an AI key is configured, asks the AI to review the staged plan for dependency issues, overloaded developers, and capacity concerns. Returns a one-sentence summary, per-sprint findings, and recommendations.
- Action buttons — Undo Changes (reverts to the original arrangement, stays in session), Accept (commits to Jira), AI Review, and Exit (cancels the session entirely).
- Delivery Forecast comparison — appears when Compare All is on, showing all four strategies side by side.
- Oversized Placement dialog — appears at Accept time when one or more issues are larger than every sprint’s capacity. Each oversized issue gets its own destination dropdown (Backlog is recommended, but any open sprint can be picked).
During a session, drag-drops between rows are local previews only — they do not write to Jira until the planner clicks Accept. Moved issues are tagged with a small badge showing where they came from and are sorted to the top of each sprint so they are easy to spot.

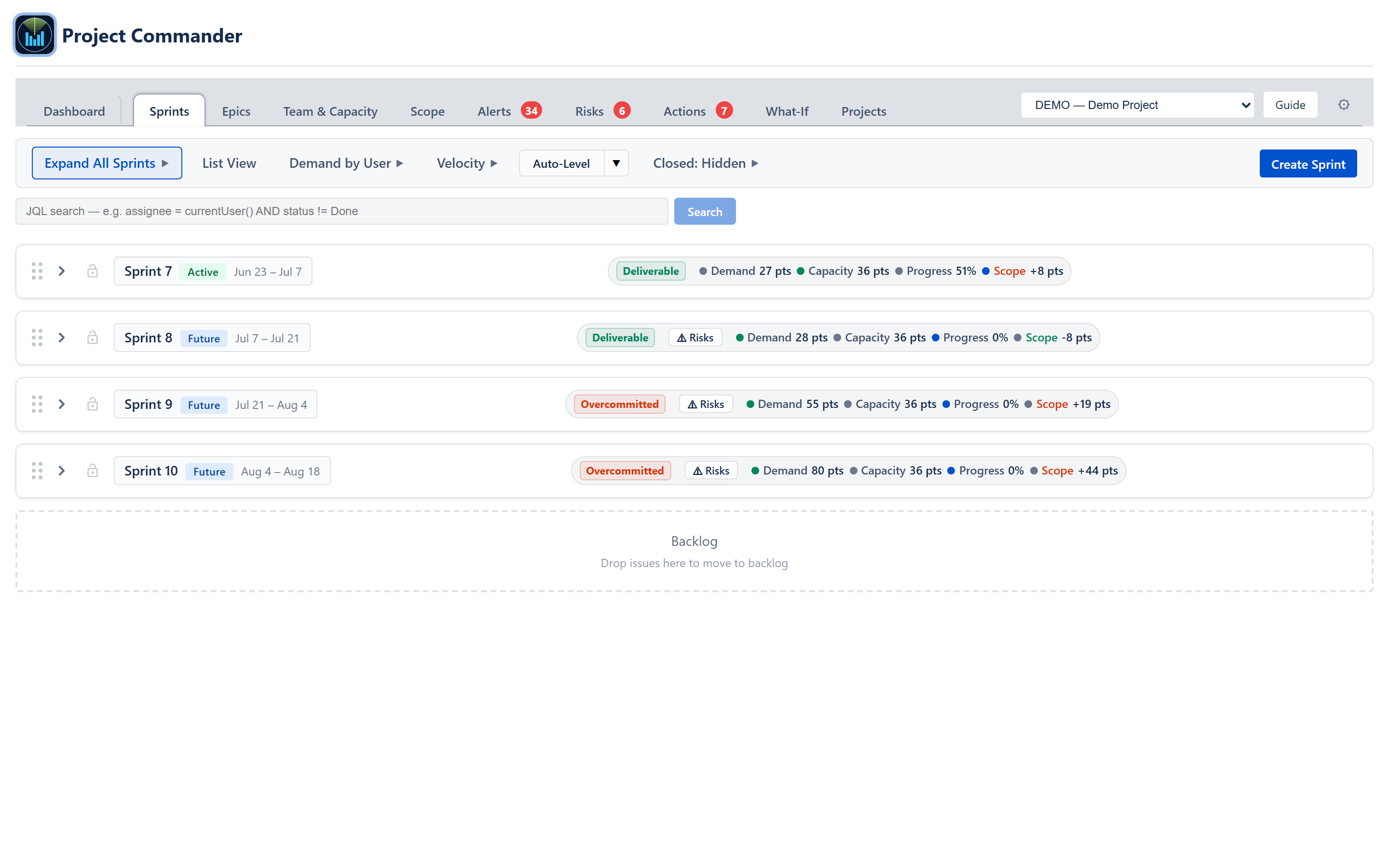

Sprint row
Every sprint, the backlog, and the virtual “Oversized Issues” row (when shown) renders as a sprint card with the same structure.
Header (always visible)
- Drag handle for reordering sprints up or down. The order is remembered.
- Collapse/expand chevron — per-sprint open/closed state is remembered.
- Sprint lock — pins every issue in this sprint during Auto-Level. Locked sprints also reject drops.
- Sprint name plus a state badge (Active, Future, or Closed).
- Clickable date range. Click to inline-edit the start and end dates; “No dates set” appears when missing.
Header stats (not shown for the backlog or oversized row):
- Deliverability badge — Deliverable, Tight, or Overcommitted. Closed sprints with all work finished show Delivered. The badge is a direct demand-versus-capacity check, so it always matches the Demand vs Capacity figures shown beside it — on first render, after a drag-drop, and after an Auto-Level session. Forward-looking pre-mortem confidence is shown in the Risks modal instead (see below), not in this badge.
- Risks button (future sprints only) — opens a Risks modal that lists risk factors and a suggested trim list of issues to defer.
- Demand — total work to deliver, in points, hours, or days. Active sprints exclude already-done work.
- Capacity — the sprint’s effective limit, derived from the chosen capacity mode for this row.
- Done — progress percentage. Mode is configurable: by points, by remaining estimate, or by work ratio (time spent versus time spent plus remaining).
- Scope — shows +N or −N change since sprint start when a snapshot exists, otherwise demand minus capacity. Red when positive, green when negative.
When the row is collapsed, the stats collapse to a single compact “demand / capacity unit” line. Action buttons (right-aligned, hidden during Auto-Level and when the row is collapsed):
- Sync Due Dates — pushes the sprint’s end date to every issue’s due date. Disabled when the sprint has no issues or no dates. Reports per-issue success and failure inline.
- Start Sprint (future only) — confirms with an explicit warning if another sprint is already active.
- Complete (active only) — opens the Complete-Sprint modal when there are incomplete issues, open action items, or risks ready to close. Otherwise a simple confirm.
- Delete (future only) — opens a destination picker if the sprint contains issues, otherwise a plain confirm.
Sprint and Status / Retro modes
Every non-backlog row has a two-button selector under the header. The Sprint button shows the planning body. The second button is state-aware:
- Future sprint — labelled “Status”, shows live progress for any work already underway.

- Active sprint — labelled “Status”, shows live actuals and projected metrics.
- Closed sprint — labelled “Retro”, opens the post-sprint retrospective. Closed rows default to this view.

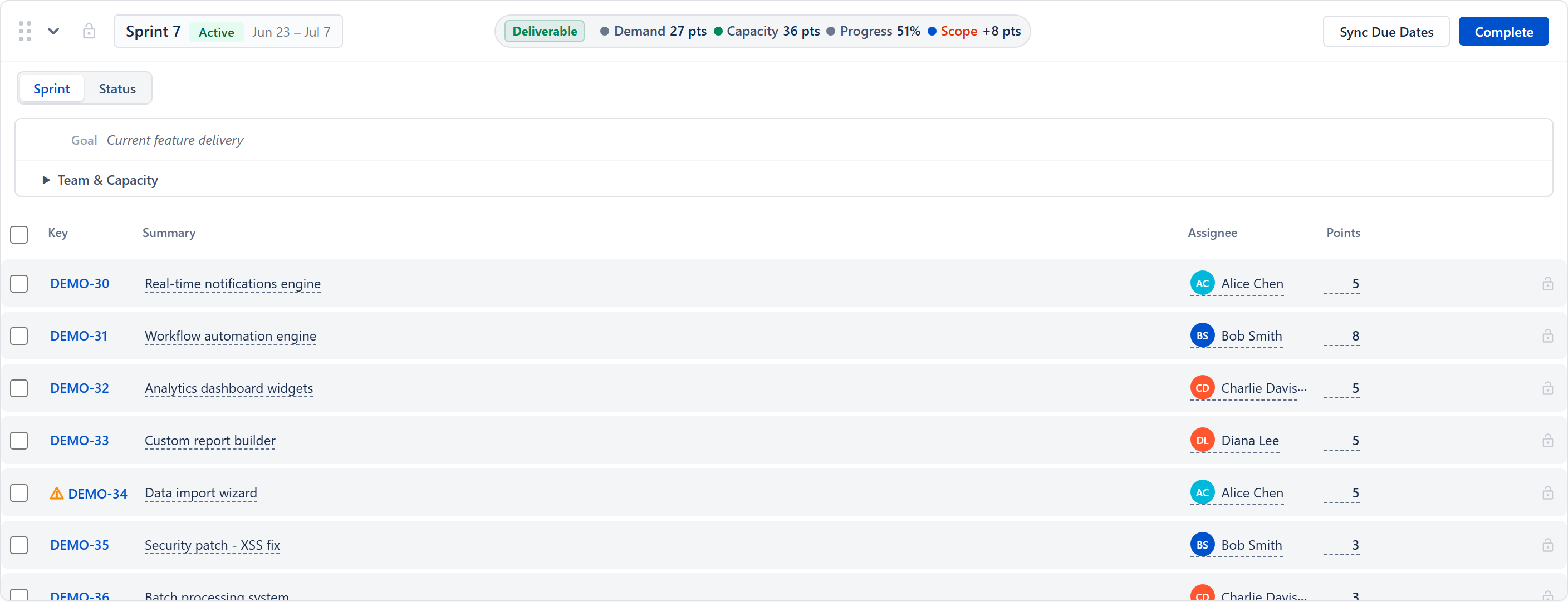

Sprint mode body
Visible when the row is expanded and Sprint mode is selected. Scope Creep Indicator (active sprints only)
Shows scope change since the sprint started. Click to expand and see original versus current totals plus lists of added and removed issues, each with deep links into Jira. Goal row
Click the goal text to inline-edit. Save or Cancel. Team & Capacity (collapsible, opens when the row expands)
- Capacity row — shows the current effective limit. Click the value to inline-edit. A dropdown lets the planner pick a capacity mode for this sprint:
- Settings default — uses the project-wide point limit.
- Team capacity — sum of all team members’ capacities for this sprint.
- Effective capacity (N%) — team capacity multiplied by historical efficiency. Only listed when there is enough velocity history to compute efficiency.
- Custom — a planner-specified number for just this sprint.
- Click a row to filter the table to just that user; click again or hit Show All to clear.
- A small “N blocked” badge appears when an assignee has blocked work.
- Capacity is editable inline. Right-click resets a per-user override.
- Status badge per member: OVERLOADED, OPTIMAL (≥ 80% of limit), or AVAILABLE.
Issue table
- Columns are dynamic — Key and Summary always show; Assignee, Points (or Hours/Days), Remaining Estimate, Original Estimate, Time Spent, Status, Type, Priority, Start Date, and Due Date can be enabled in project settings.
- Click any column header to sort ascending, again for descending, again to clear.
- Bulk select via header and per-row checkboxes. Selecting one or more issues opens a sticky toolbar at the top with: count of selected, Move to backlog, Set priority (Highest, High, Medium, Low, Lowest), and Clear.
- Drag any row to another sprint to move it. If the dragged row is part of a multi-select, the whole selection moves together. Drop on another row in the same sprint to reorder. Drop on the backlog area to move to backlog. Locked issues are filtered out of any drop. Auto-scroll kicks in near the top and bottom of the viewport during a drag.
Inline cell editing
Editable cells share a visual affordance: a dashed underline, a pointer cursor on hover, and a Click to edit … tooltip. The click target has a minimum width so cells that display 0, —, or an empty value are still easy to hit (previously zero-valued cells could collapse to a near-zero hit box and feel unclickable).
- Key — opens the issue in Jira. A warning icon appears when the issue is blocked by something in a later sprint.
- Summary — click to edit text. Enter saves; Escape cancels.
- Assignee — click to open a dropdown of the active team members plus Unassigned. The dropdown floats above the table on a portal layer so it is never clipped by row or table overflow. Optimistic update with rollback on error.
- Story points — click to edit (points mode only). Zero-valued and unestimated cells share the same dashed-underline hit target.
- Original Estimate — click to edit (time mode only; column header reads Time (hrs) or Time (days)). Same dashed-underline affordance; zero-valued cells are clickable.
- Status — click to open a transition list fetched live from Jira; No transitions available when none apply.
- Priority — click to choose from the five-level palette with coloured dots.
- Due date — click to open a date picker; past-due dates are highlighted on non-done issues.
- Time Spent and Remaining Estimate are read-only and formatted in hours or days.
- A warning icon appears in points, original-estimate, or remaining-estimate cells when an issue is larger than the sprint’s capacity.
- A per-row lock button keeps that issue in place during Auto-Level. During a session, moved issues show a small “← FromSprint” badge.
Quick Create issue A “+ Create issue” link at the bottom of each sprint expands into a small form with an issue type dropdown (Story, Task, Bug, Sub-task), a summary input, and Add or Cancel. Hidden in read-only mode and in demo modes.
Complete-Sprint modal
Opens when an active sprint is being completed and there are incomplete issues, open action items, or risks whose mitigation is fully done. Sections shown as needed:
- Incomplete issues — choose Backlog (the default), one of the existing other sprints (each shown with its current points total), or Create new sprint.
- Closeable risks — one checkbox per risk whose mitigation actions are all complete; tick to mark closed on confirm.
- Open action items — per-item radio with three choices: roll over to a chosen future sprint, mark done, or leave on this sprint. A “Roll all over” bulk control with a destination picker and Apply appears when there is more than one item.
Confirm executes the action-item dispositions, the risk closures, the issue moves (or sprint creation and move), and finally completes the sprint. The view refreshes on success.
Delete-Sprint modal
Future sprints with issues open a destination picker — Backlog or another sprint. Confirm moves issues, then deletes the sprint. Future sprints with no issues just show a plain confirm.
JQL Search
Above the sprint list. The planner can type a JQL query and press Enter or click Search. Results appear in a collapsible table (key with link, summary, assignee, points, status badge), capped at fifty rows. Clear resets the search.
A persistent Create Issue button sits at the right end of the row (hidden in read-only). It opens a popover with a project dropdown, an issue type dropdown, a summary input, and inline success or error feedback.
Backlog row
Sits below the sprints. Same card structure but with no header stats, no actions, no mode selector, and no per-user table — just the issue table and a count line. When empty, the backlog renders a drop zone so issues can still be dragged in.
Oversized Issues row
A virtual row that appears at the bottom of the sprint list during Auto-Level when one or more issues are larger than every sprint’s capacity. Capacity controls and drag are disabled. A banner explains that Backlog is recommended, and the planner picks a destination for each oversized issue at Accept time.
Cross-cutting modes and settings
- Estimation mode — Points or Time. Time mode swaps points for hours or days everywhere in the tab.
- Time unit — Hours or Days. Drives the displayed unit and the conversion of estimates.
- Capacity mode — Per Sprint or Per User. Per User mode tracks a per-assignee limit, flags individuals as overloaded, and shows the capacity editor as count × per-user.
- Per-sprint capacity — each sprint can be set to Settings default, Team capacity, Effective capacity, or a custom number.
- Sprint and issue order — manual reordering of sprints and of issues inside a sprint is remembered.
- Read-only mode — hides Create Sprint, Quick Create, lock toggles, inline edits, drag, and batch actions. Auto-Level still runs but Save is blocked with a “preview only” notice.
- Demo mode — substitutes a sample dataset and never writes to Jira.
- Program-All mode — the Sprints tab is hidden in favour of a notice asking the user to pick a single project.
- Locks — per-issue and per-sprint locks are honoured by Auto-Level (locked things never move) and by drag-and-drop (locked rows can’t be dragged; locked sprints reject drops).
How the numbers are computed
- Auto-Level (Per Sprint mode) — walks the open sprints in order, applies the chosen strategy to order issues, places each one into the first sprint where it fits, and never exceeds capacity. Overflow spills into proposed new sprints, capped at a safe maximum. Locked issues stay put; locked sprints are skipped.
- Auto-Level (Per User mode) — tracks per-user demand inside each sprint, uses each user’s personal cap, scans subsequent sprints for room, then proposes new sprints if needed. Same overflow guard.
- Effective capacity — team capacity multiplied by the team’s historical efficiency (delivered ÷ planned).
- Calculated capacity per sprint — comes from the Team & Capacity tab and contributes total points, total hours or days, and per-member capacities.
- Future-sprint confidence — a Monte Carlo simulation over velocity history, with adjustments for unestimated, large, and blocked items. Mapped through three confidence bands and surfaced in the per-sprint Risks modal (it no longer drives the header deliverability badge).
- Save — compares the staged plan with the original baseline, computes the net moves, and sends them to Jira along with any newly proposed sprints. Backlog moves are sent separately.
Effects on other parts of the app
- Demand by User: selecting a user filters work everywhere via the global user filter.
- Velocity Lookback: changing it here changes it for every tab.
- Include backlog: affects Auto-Level and every other view that consumes the backlog.
- Closing risks from the Complete-Sprint modal updates the global risk register.
- Action-item rollovers append the source sprint id to the action item so the destination shows the rollover provenance.
- Date sync writes individual issue due dates and triggers a refresh once finished.
